End-to-End DC Build

Powering the future with resilient, intelligent, and value-driven data infrastructure.

End-to-End DC Build
Complete Turnkey Data Center Solutions

Complete Turnkey Data Center Solutions

Future Netwings, in collaboration with G2S, offers end-to-end solutions for high-performance data centers. We integrate civil engineering, MEP systems, and ICT infrastructure into a single, robust offering — reducing handovers, risk, and delays.

Key Highlights:

  • bulletGreenfield & Retrofit Projects
  • bulletTier II/III/IV Certified Infrastructure
  • bulletCivil, HVAC, Fire, Plumbing, Electrical
  • bulletIT Networks, Servers, Structured Cabling
Phased Engineering & Delivery Methodology

Phased Engineering & Delivery Methodology

Our structured execution model ensures consistent quality, fast deployment, and audit-ready results.

Planning & Design: Layout, compliance, site evaluation

Power & Cooling: UPS, rPDUs, liquid cooling

Fire Systems: FM-200, VESDA, Pre-Action sprinklers

BMS + DCIM: Central monitoring, automation

IT & Networks: Cabling, switching, load balancing

Testing & Handover: Failover simulation, SOPs, AMC

Post: Build Services

Phase 1: Planning and Design

1

Feasibility Study

  • Site evaluation
  • Regulatory & environmental assessments
  • Risk analysis (natural disaster, power, telecom reach)
2

Data Center Design

  • Architecture (Tier II/III/IV as per Uptime Institute)
  • Capacity planning (Power, Cooling, IT Load)
  • Civil structure layout
  • Scalability & modularity design
3

Consulting & Compliance

  • Uptime Tier Certification, TIA 942, ISO 27001
  • Green Building (LEED), MoEF guidelines
  • Financial modeling & ROI projection
Data Center Diagram

Site Selection Parameters

Data Center Diagram
1

Geotechnical Conditions

  • Soil bearing capacity, Water table level, Seismic Activity
  • Ensure site is outside flood zones and has proper drainage systems
  • Accessibility in terms proximity to roads, fiber networks, and power sources
  • Comply with local zoning laws and security regulations
2

Structural Design Parameters

  • Load-bearing capacity: For heavy equipment like servers, batteries, and cooling units
  • Seismic and wind load resistance based on regional hazard maps (e.g., seismic zone classification)
  • Vibration control which is important to prevent disruption to sensitive equipment
  • Expansion joints and redundancy to allow for future expansion or infrastructure failure

Space Planning and Layout

1

Floors & Ceilings

  • Slab-on-grade design with overhead cable trays and ducts
  • Sufficient ceiling height to accommodate HVAC, power, and fire systems
2

Functional Zoning

  • Segregated areas for IT halls, electrical rooms, battery zones, cooling plants, and support spaces
  • Clear pathways for equipment movement and maintenance
3

Modularity & Scalability

  • Designed for phased expansion and future capacity upgrades
  • Supports hot aisle/cold aisle layouts for energy-efficient operations
4

Operational Efficiency

  • Optimized equipment spacing, access corridors, and service zones
  • Strategic placement of entry/exit points and utility shafts
Data Center Diagram

Power Distribution Architecture & Redundancy

Data Center Diagram
1

Power Flow Path

  • Utility → Generator → ATS → UPS → PDU → rPDU
  • Ensures seamless and conditioned delivery to IT systems
2

Redundancy Models

  • N, N+1, 2N, 2(N+1) configurations
  • Fault-tolerant design ensures high uptime and continuity
3

Busway Systems

  • Modular overhead/underfloor routing
  • Safer and lower-maintenance than traditional cabling

Power Delivery Systems & Management

1

UPS Technologies

  • Double Conversion, Line Interactive, and Modular UPS
  • Scalable and serviceable for all load conditions
2

PDUs & rPDUs

  • Basic, Metered, Switched, and Intelligent PDUs
  • Enable power metering, remote switching, and rack-level insights
3

Power Monitoring & DCIM

  • Real-time load, temperature, and PUE tracking
  • Enables predictive maintenance and energy optimization
Data Center Diagram

Innovation & Energy Efficiency

Data Center Diagram
1

Power Innovation Trends

  • Lithium-ion batteries, DC power distribution
  • Edge-ready compact designs and AI load optimization
2

Renewable Energy Integration

  • Solar, wind, and green grid sources
  • Designed for sustainable and hybrid energy models
3

Energy Efficiency Metrics

  • PUE = Total Facility Power / IT Load Power
  • Ideal target: <1.5 with continuous optimization via DCIM

Phase 2: HVAC & Cooling Systems

1

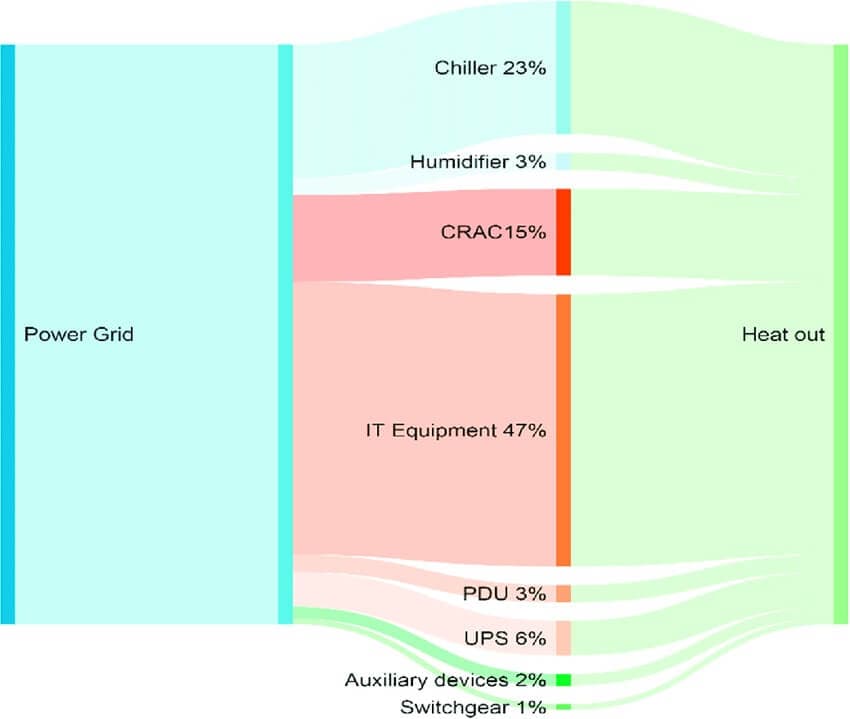

Precision Cooling

  • CRAC/CRAHs, In-row cooling, underfloor/overhead
  • Hot aisle/cold aisle containment
2

Chillers & Condensers

  • Air-cooled/water-cooled chillers
  • Pumping systems and redundant loops
  • Integration with Data Center Cooling Systems
3

Ventilation & Environmental Control

  • Fresh air systems, AHUs
  • Humidity control & monitoring
4

Advanced Cooling Technologies

  • DCLC (Direct-to-Chip Liquid Cooling)
  • Liquid Immersion Cooling System
Data Center Diagram

Safety & Security

Data Center Diagram
1

Fire-Rated Civil Works

  • Minimum 2-hour rated walls, doors, and service penetrations to support containment and suppression systems
2

Access Control Zones

  • Physical barriers and structured zones (e.g., mantraps, security booths) for controlled access to critical areas
3

Fire Suppression Integration

  • Civil design aligned with gas-based or water-mist suppression systems to minimize equipment damage
4

Emergency Egress Compliance

  • Clearly defined escape routes and exits designed per fire safety and building codes

Phase 3: Fire Detection & Suppression

1

Fire Detection

  • Addressable Fire Alarm Systems (VESDA, smoke detectors)
2

Suppression Systems

  • FM-200/Novec 1230 gas suppression
  • Sprinklers, hydrants, extinguishers
  • Pre-Action Sprinkler Systems
  • • Single Interlock
  • • Double Interlock
3

Zonal Segmentation

  • Dedicated systems for server rooms
  • Dedicated systems for electrical rooms
Data Center Diagram

Phase 4: Building Management System (BMS)

Data Center Diagram
1

Central Monitoring

  • HVAC, power, lighting, access control integration
2

DCIM Integration

  • Rack-level energy monitoring, asset tracking
3

Smart Automation

  • Alerts, failover logs, predictive maintenance

Phase 5: ICT Infrastructure

1

Structured Cabling

  • Fiber & copper, server-to-core design
  • Cable management, patch panels, raceways
2

DCIM Integration

  • Core, distribution, access switches
  • Routers, firewalls, load balancers
3

Smart Automation

  • CCTV, biometric access, perimeter security
  • NAC, WAF, endpoint protection
Data Center Diagram

DC Active & Passive Infra Build-up

Data Center Diagram
1

Data Center Passive Infrastructure

  • Designing of entrance facility ISP termination
  • Designing of entrance facility to Meet-Me Room (MMR) fiber connectivity via cable tray
  • Designing of MMR room to EoR/MoR (Data Hall) high-density fiber backbone connectivity via Fiber Runner
  • Designing of high-density fiber and copper connectivity from EoR/MoR to server rack via FGS and wire mesh
2

Data Center Active Infrastructure

  • Designing of 10G/40G/100+G Leaf & Spine network switching architecture
  • Designing of application specific network infra build-up with SDN functionalities
  • Designing of simplified customized network management, automation, network scalability, network isolation, and multi-cloud capabilities
  • Designing of open ecosystem of network, storage, management, and orchestration with integrated physical and virtual infrastructure

Cybersecurity & Risk Management – ICT

1

Perimeter & Network Security

  • Firewalls, IDS/IPS, and network segmentation
  • Isolates sensitive zones and prevents lateral threats
2

Access Control & Identity Management

  • Role-based access and multi-factor authentication (MFA)
  • Enforces least privilege principles for both physical and digital entry
3

Data Protection & Real-Time Monitoring

  • Encryption of data at rest and in transit with secure backups
  • SIEM-enabled monitoring for threat detection and incident visibility
4

Compliance, Audit & Response Readiness

  • Adherence to ISO 27001, GDPR, PCI-DSS, etc.
  • Regular audits, penetration tests, and defined response protocols
Data Center Diagram

Phase 6: Testing, Commissioning & Handover

Data Center Diagram
1

System Integration Testing (SIT)

  • All systems validated for functionality and failover
2

Commissioning

  • Tier-wise commissioning (Level 1–5)
  • Load testing, failover simulation
3

Handover & Documentation

  • SOPs, as-built drawings, AMC plan

Post – Build Services

1

Facility Management & AMC

  • Onsite/remote support, 24x7 monitoring
  • Preventive & predictive maintenance
2

Managed NOC Services

  • Infra, network & security operations monitoring
3

Upgrades & Retrofits

  • Lifecycle management, DC expansion, energy optimization
Data Center Diagram
Security, Resilience & Compliance

Security, Resilience & Compliance

Security and compliance are integral to every project, ensuring long-term viability and trust.

Key Areas:

  • bulletCybersecurity: Firewalls, IDS, NAC, segmentation
  • bulletAccess Control: MFA, RBAC, biometric systems
  • bulletData Protection: Encryption, backups, real-time monitoring
  • bulletCompliant With: ISO 27001, PCI DSS, HIPAA, SOC 2, TIA-942
AI-Driven NOC/SOC & Smart Management

AI-Driven NOC/SOC & Smart Management

Our AI-ready infrastructure includes full-fledged NOC/SOC solutions, giving you deep visibility, automation, and control.

Capabilities:

  • bullet24/7 AI-Based Monitoring
  • bulletThreat Detection & Incident Response
  • bulletPerformance Optimization & Predictive Maintenance
  • bulletAI DevOps for continuous workload management
Post-Build Support & Lifecycle Management

Post-Build Support & Lifecycle Management

Post-commissioning, we offer complete facility support, helping clients maintain uptime and scale effortlessly.

Support Includes:

  • bulletRemote & Onsite AMC
  • bulletLifecycle Upgrades & Retrofitting
  • bulletEnergy Optimization & Reporting
  • bulletExpansion Planning & Infra Audits

Our Data Center Eco System Partnership

Trusted brands we work with across networking, power, cooling, security and more.

  • Cisco
  • HPE
  • Juniper
  • Arista
  • CommScope
  • Siemens
  • Honeywell
  • Gyproc
  • VESDA
  • Kidde
  • Bosch
  • Carrier
  • Blue Star
  • Honeywell
  • Bosch
  • Rittal
  • NetRack
  • Schneider Electric
  • Vertiv
  • Schneider Electric
Our Project Portfolio

Our Project Portfolio

We’ve successfully executed major data center projects for governments, enterprises, and smart cities.

Client Highlights:

  • bullet
    Techno Data Center - Chennai
  • bullet
    Techno Edge Data Centre - Gurgaon
  • bullet
    PricewaterhouseCoopers DC Kolkata
  • bullet
    IIT Kharagpur
  • bullet
    TCS - Gitanjali Park ODCs, Kolkata
  • bullet
    Rajasthan State Data Center - Jaipur*
  • bullet
    Rajasthan Disaster Recovery Centre - Jodhpur*
  • bullet
    STPI DC - Bhubaneshwar*
  • bullet
    West Bengal State Data Center*
  • bullet
    Presidency University DC*
  • bullet
    Ordinance Factory Board DC & DR (Kolkata & Nagpur)*
*Through partners
Certification & Policy Consulting

Certification & Policy Consulting

We help you prepare for and pass the world’s leading data center certifications — from ISO to Uptime.

Support Includes:

  • bulletDocumentation & SOPs
  • bulletAudit Preparation
  • bulletRisk & Process Alignment
  • bulletCertification Readiness (Uptime, ISO 27001, SOC 2, LEED, PCI DSS)

Our DC Case Studies

Case Study 1 – Rajasthan State Data Center

MSI- Sterling & Wilson

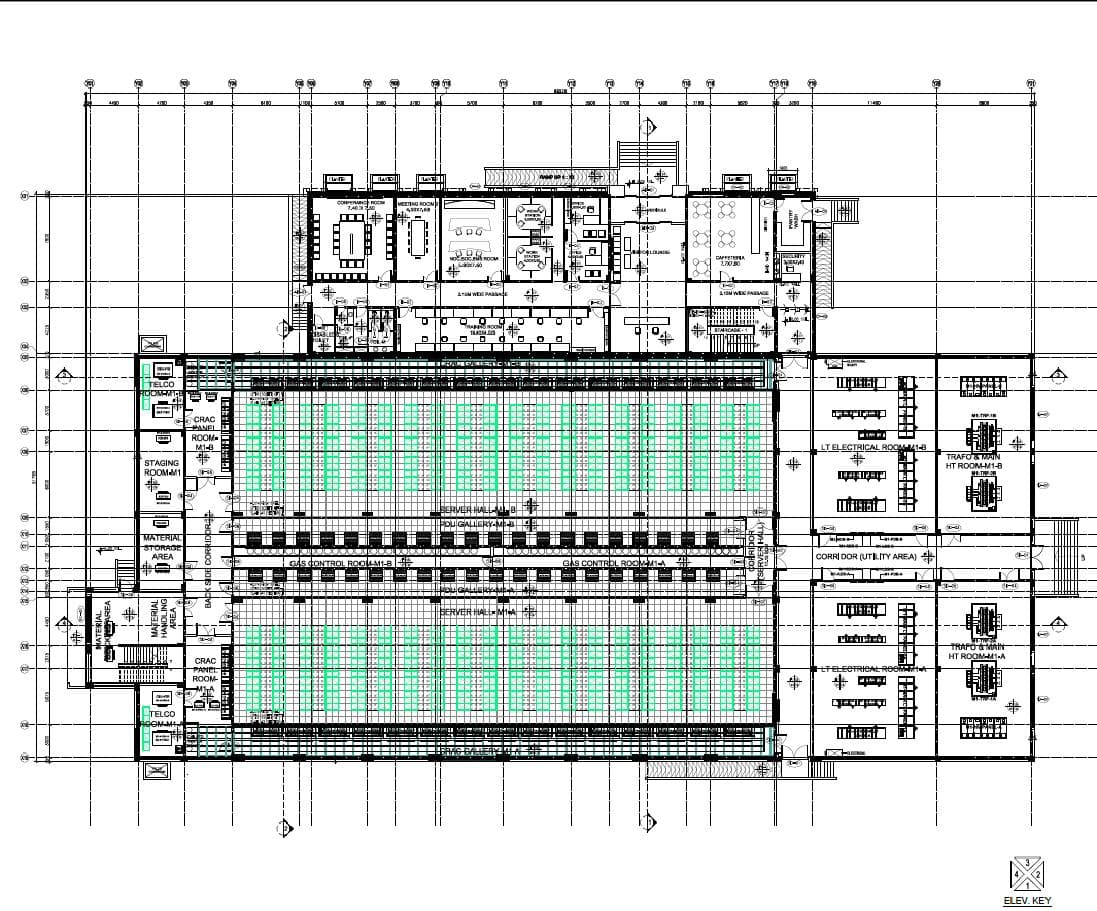

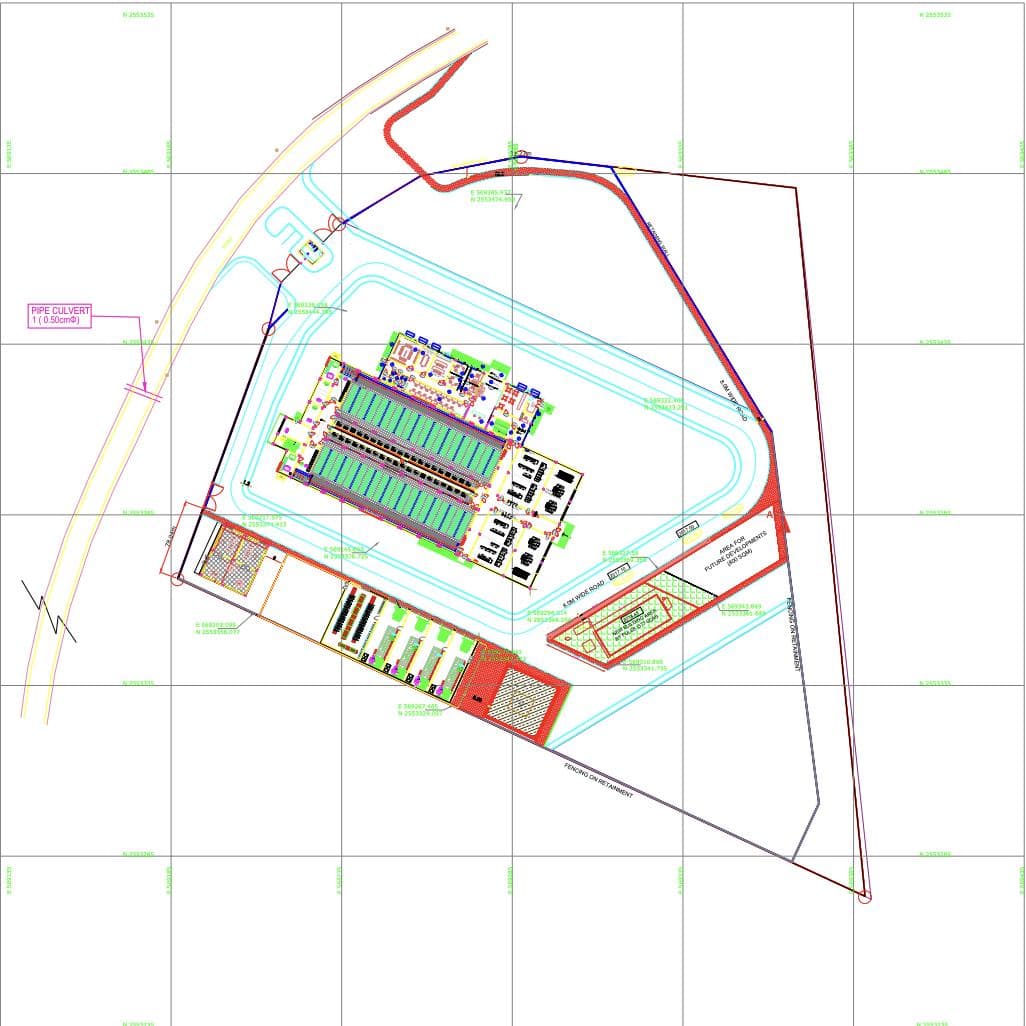

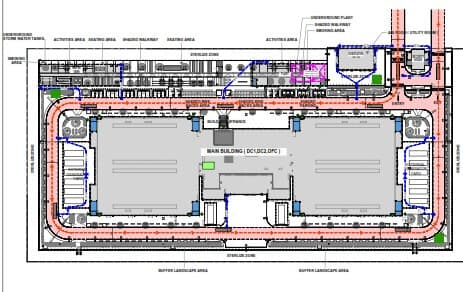

Rajasthan State Data Center building
Project Brief

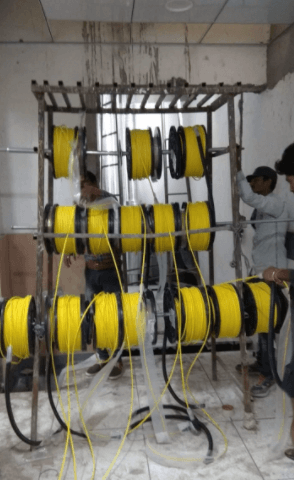

Turnkey Intelligent Structured Cabling designing, supplying and commissioning of ground +6 - storey building and 650 nos 43U racks Data Center System with the involvement of 10 nos in-house design engineers and 50+ skilled technicians, Liasoning works with other stakeholders and etc. Our Intelligent Data Center Structured Cabling Project has achieved the part of Uptime Institute’s Tier IV Design certification.

Commscope Passive Data Center Solution

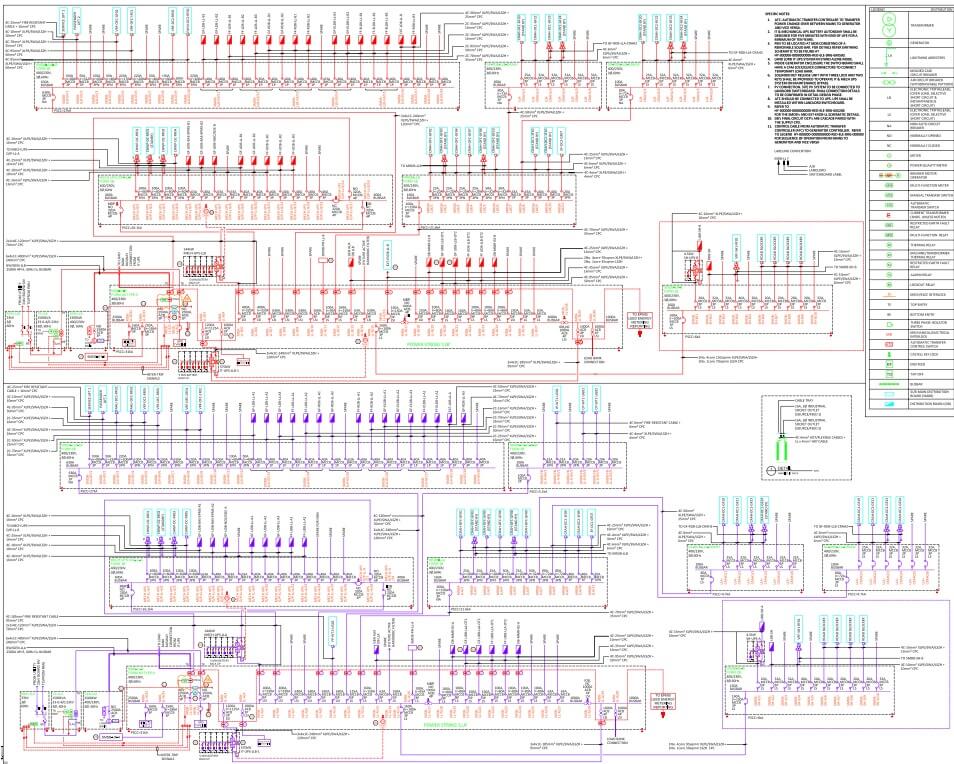

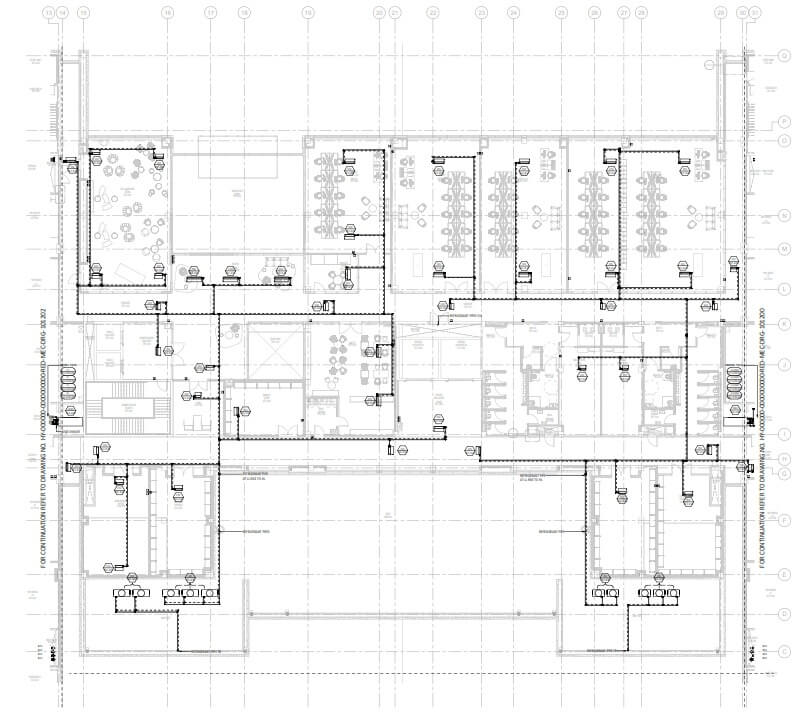

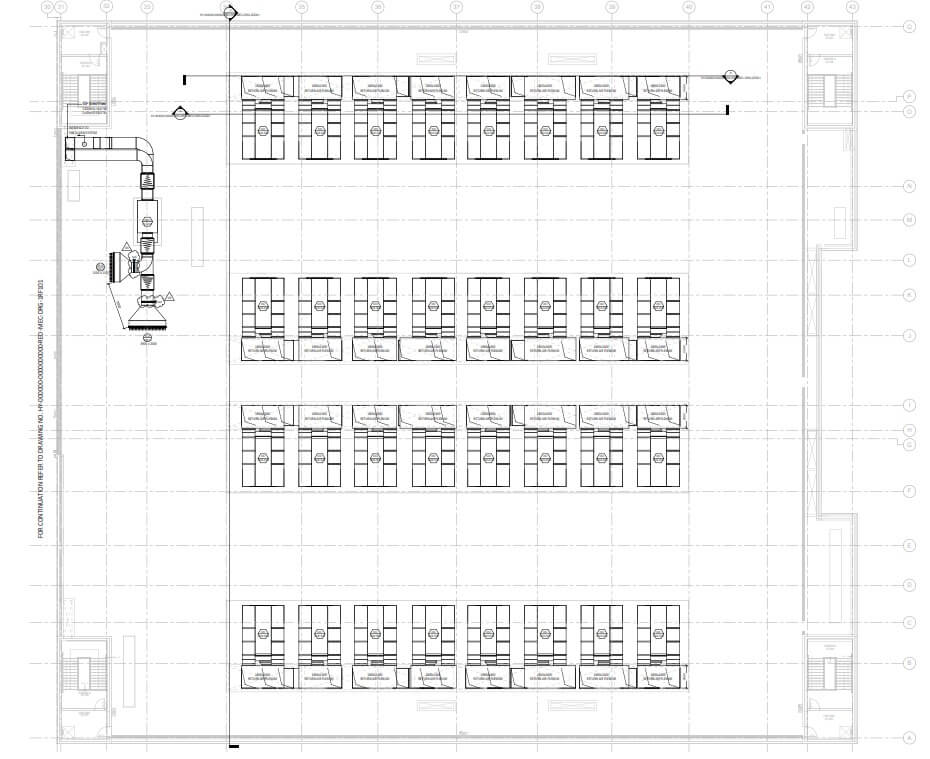

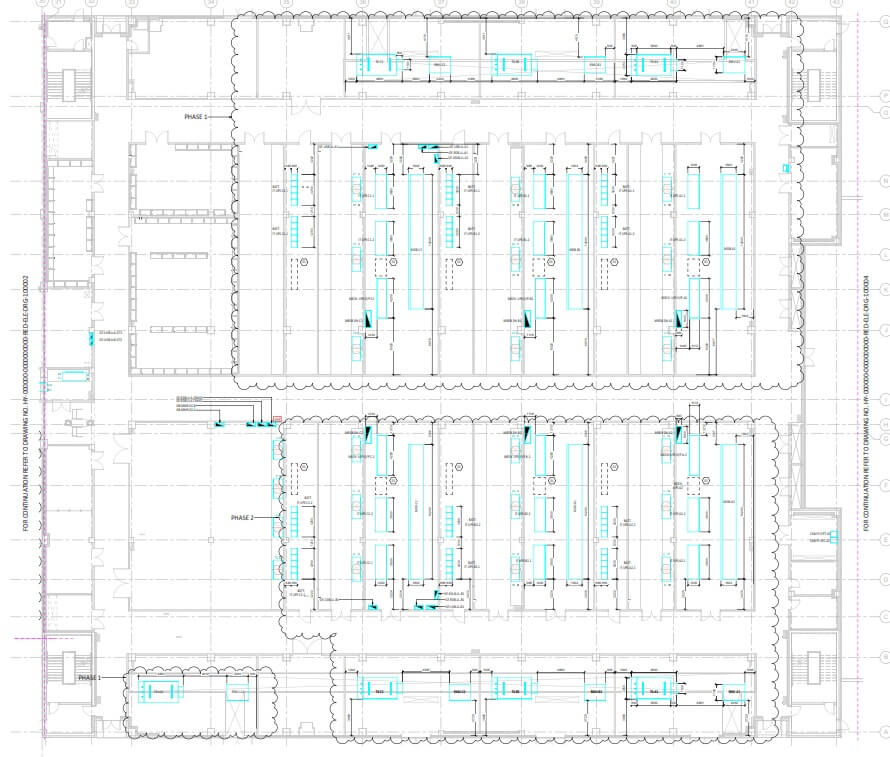

  • Use 24 Fiber OM4 Pre-Terminated Rack to Rack Trunk Cable – 33810 Mtr
  • Use SM 24 Fiber Pre-Terminated Trunk Cable – 79230 Nos
  • Use LC-LC, OM4 MM 10 Mtr 50/125 Patch Cord – 48500 Nos
  • OM4, MPO Cassette, 24 LC fibers (12 duplex ports) – 1732 Nos
  • 1U Sliding modular cassette shelf, accepts 4 MPO cassettes – 1200 Nos
  • LC-LC, SMF Patch Cord – 62000 Nos
  • CAT 6A LSZH, ETL Verified Category 6A U/UTP Cable Box – 380 Nos
  • CAT6A Patch Cords – 20300 Nos
  • Fiber Guide Pathway System – 1558 Mtr
  • Cable management wire basket Pathway System – 1200 Mtr
Intelligent Passive Solution
  • Use Commscope Intelligent Upgrade Kit for HD Shelf, 6PK Kit – 155 Nos
  • Use Commscope Intelligent Upgrade Kit, 5PK Kit – 6 Nos
  • Use Commscope Intelligent Ready CAT 6A U/UTP Patch Panel, 24 port – 130 Nos
  • Use Commscope AIM Software with unlimited Port License – 1 No
  • Use Commscope Software Maintenance Pack for 5 Years
Implementation Workflow
Fiber and CAT6A Laying

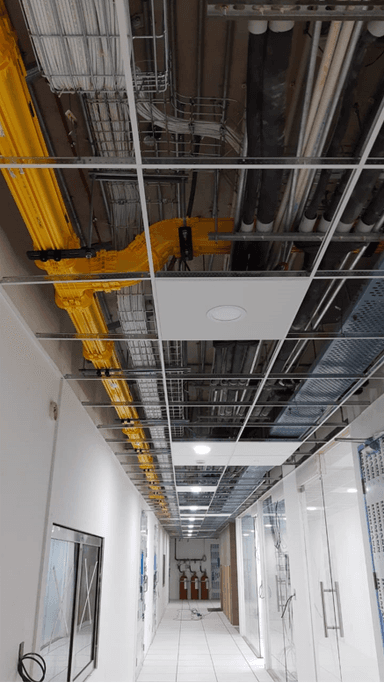

Fiber and CAT6A laying 1Fiber and CAT6A laying 2
Bhamashah DC Final Handover
Bhamashah DC final handover
Fiber and CAT6A Dressing

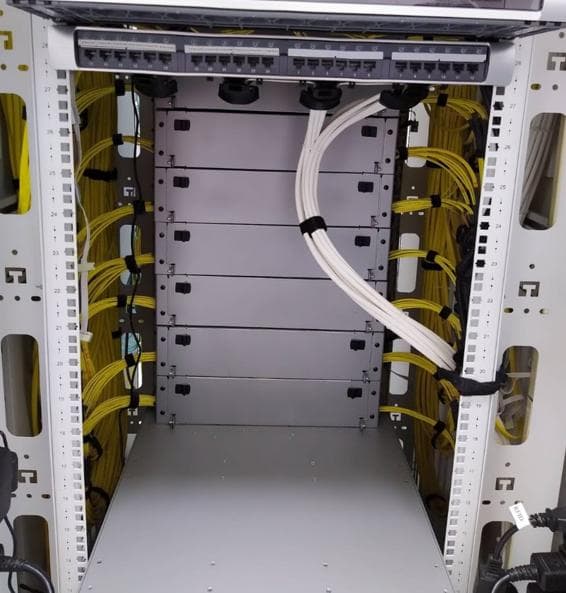

Fiber and CAT6A dressing 1Fiber and CAT6A dressing 2

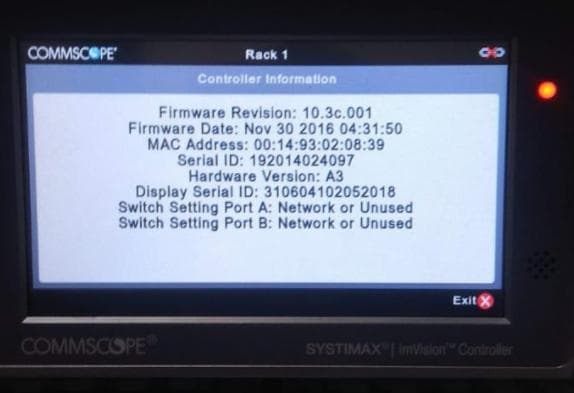

Fiber and CAT6A Monitoring System
Fiber and CAT6A monitoring system
Case Study 2 – STPI Bhubaneswar Data Center

MSI- Sterling & Wilson

Rajasthan State Data Center building
Project Brief

Private Cloud designing, supplying and commissioning of ground +12 - storey building and 100 nos 42U racks Data Center System with the involvement of 15 nos in-house Network and Cloud design and implementation engineers and 15+ skilled passive technicians.

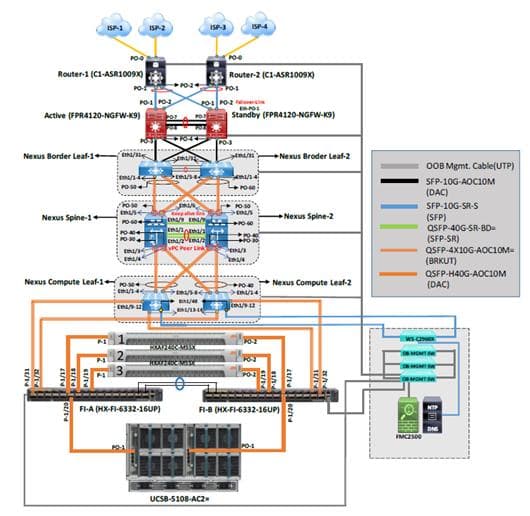

Active Cloud Data Center Solution
  • Use Cisco UCS 5108 Blade Server
  • Use Cisco HX 240C M5 Hyperflex HCI System
  • Use Cisco Compute UCS B200 M5 Blade System
  • Use Cisco UCS 6332-16UP 1RU Fabric Interconnect System
  • Use VMware vCenter 6 Server Standard, SUSE Linux, Microsoft Package
  • Use Cisco Workload Optimization Manager
  • Use Cisco Cloud Management Suite and UCS Director Automation Suite
  • Use Cisco ASR1009 Router and Cisco Firepower 4120 Firewall
  • Use Cisco Nexus 9504 Chassis as a Spine Switch
  • Use Cisco N9K-C93180YC-FX as a Leaf Switch
Intelligent Passive Solution
  • Use Commscope MPO to MPO, 12-Fiber
  • Use Commscope LC-LC Multimode 50/125 micron OM4 Duplex Patch Cord
  • Use Commscope Cat 6A F/UTP 23 AWG Cable
  • Use Commscope CAT 6A,S/FTP Patch Cord
  • Use Commscope Jack and Patch Panel
  • Use Commscope 4 x 4 Fiber Guide Pathway System
  • Use Commscope Copper Pathway Wire Basket
STPI Data Center EntranceData Center Entrance
STPI BBSR Data Center Topology

STPI BBSR Data Center Topology

Fiber Guide System
Fiber Laying Guide 2

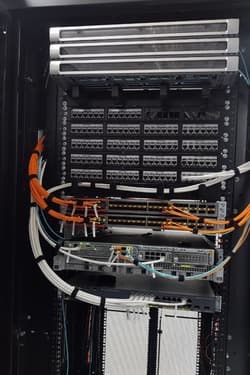

Rack Dressing
Rack DressingFiber Laying Guide 1
Inter Rack Connectivity
Rack ConnectivityRack Connectivity
Case Study 3: Design & Consultancy experience/Capability showcase (For a 3.4MW Tier III Greenfield DC in Muscat)
Rajasthan State Data Center building
Project Brief

Using 35+ Years of experience a Data center was designed for the Government of Oman, At Muscat, with Tier- III Uptime Institute Certification for Design.

The Site Location was on a Hill of 2000 m above sea level, rocky area, about 4.5 Acres land was allocated.

Space allocated for future development as well as Employees Residential buildings. The IT Load was 2.08 MW. and Facility Load was 3.78 MW

Space Allocated and MEP Equipment's Considered
  • Space planning done to accommodate 520 IT Racks in 2 Server Halls.
  • Dual Telco Rooms, Electrical Rooms, Material handling area, and Office space included.
  • Designed facility to meet Uptime Institute Tier-III Standards and obtained Design Certification.
  • Electrical System in N+N Configuration with proposed 11 KV Rotary UPS (DR-UPS) feeding Transformers to step down to utility voltage for the entire facility.
  • Mechanical System in N+1 Configuration with Chiller Plant on Terrace and CRAH for Server Halls.
  • FCUs and AHUs provided for Non-Critical area cooling purposes.
  • Novec 1230 Gas system implemented for Fire Suppression.
  • BMS, CCTV, EPMS, VESDA, WLD, Access Controls, and FAS integrated into the facility.
Advantage of Rotary UPS
  • UPS power continuously available for every equipment of the data center, power outlets, and the entire campus.
  • All cooling units remained in continuous operation even during power failure conditions.
  • Automatic correction of Power Factor ensured stable and efficient operations.
Case Study 3— Design & Consultancy experience/Capability showcase (For a 3.4MW Tier III Greenfield DC in Muscat)

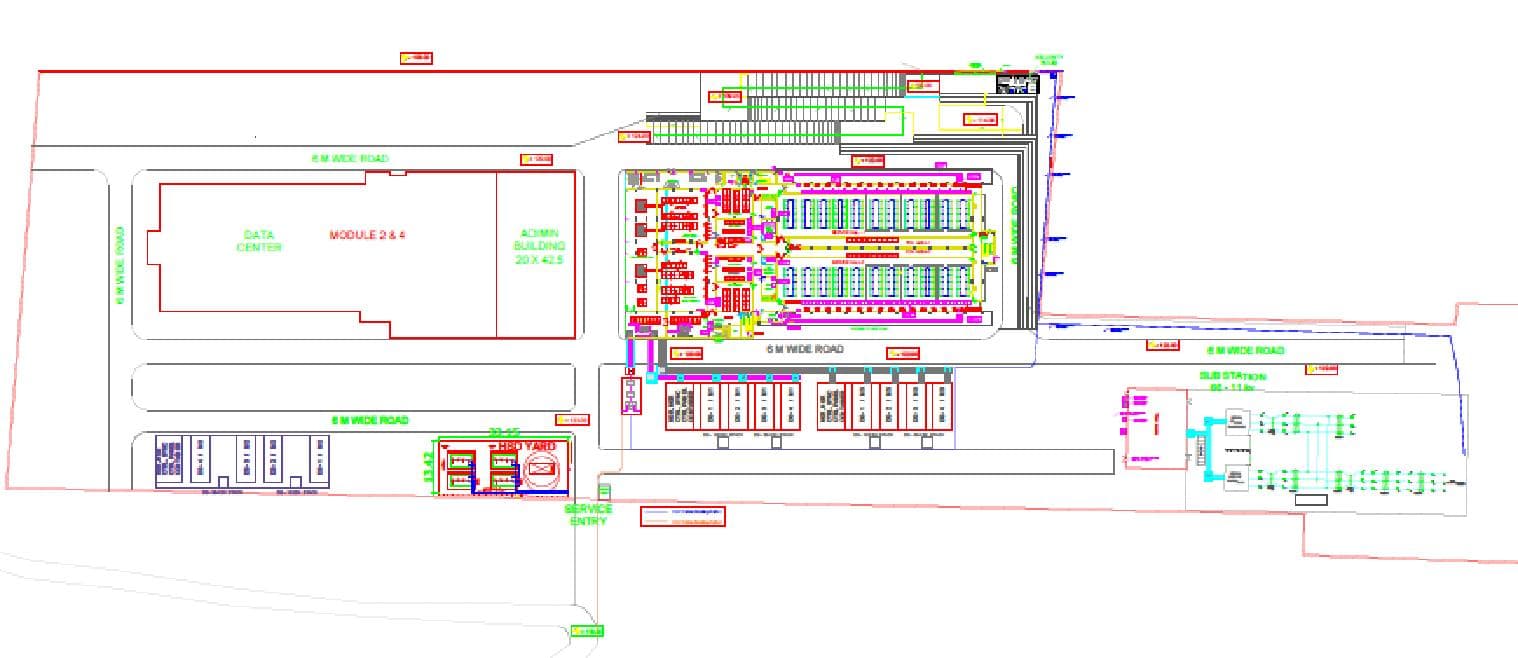

Campus Layout

Campus layout drawing

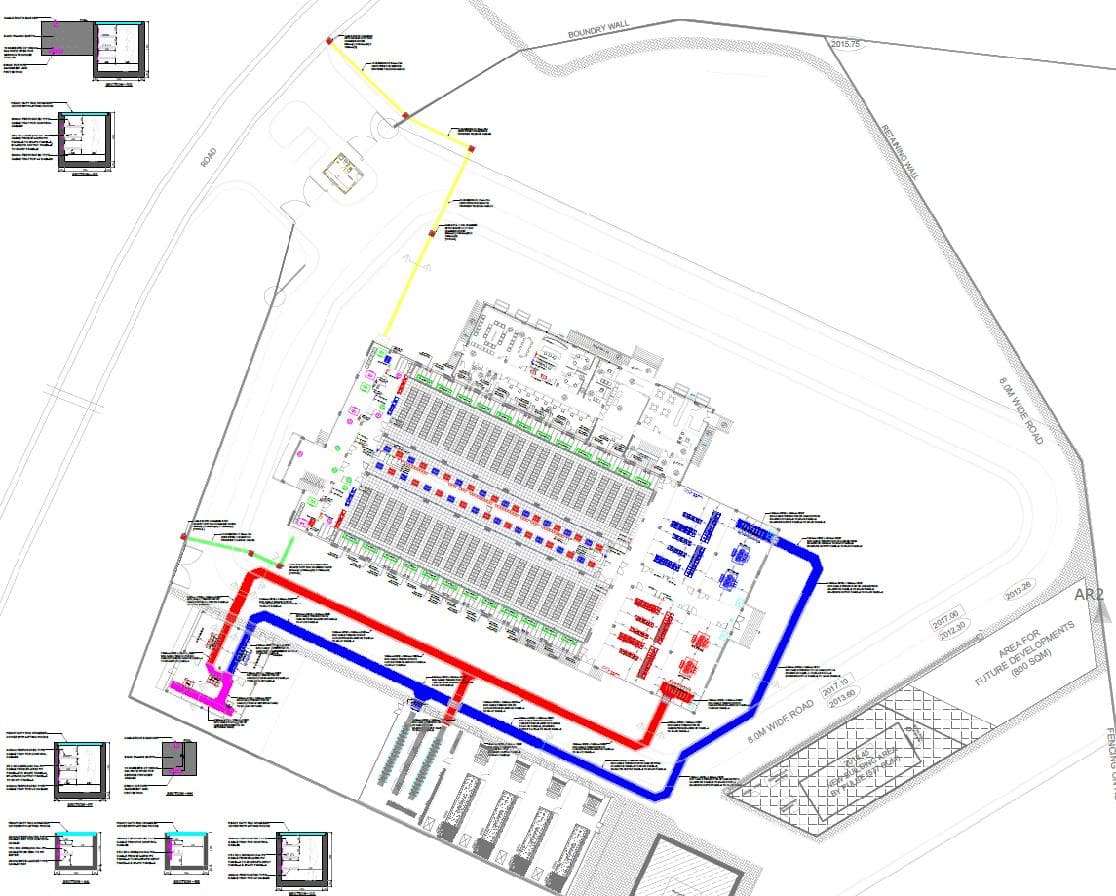

Datacenter Site Plan
Datacenter site plan
Power and OFC Trenches
Power and OFC trench routing

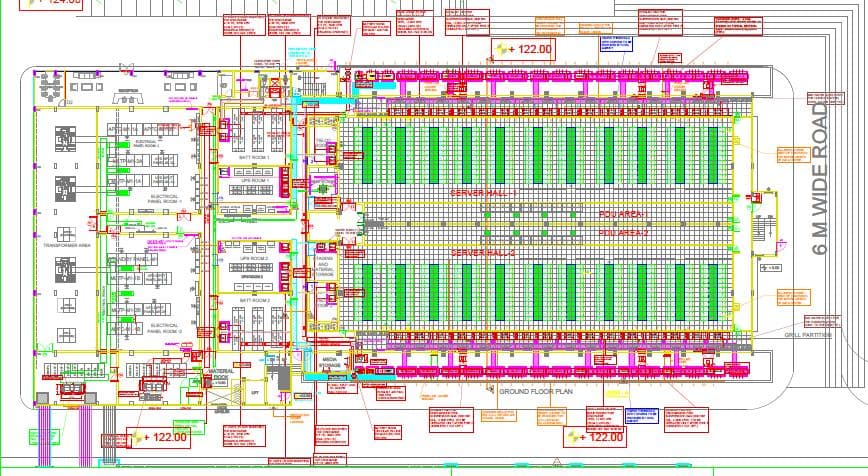

Data Hall Equipment Layout
Data hall equipment layout
DR-UPS Room Layout
DR-UPS room layout
Design Consideration
  • IT Load: 2.25 MW
  • Total Facility Load: 3.78 MW
  • No. of IT Racks: 520, Rack Power Density: 4 kW
  • Datacenter Rating: Uptime Institute Tier III (Compliant)
  • Uptime Certification: Tier-III Design certified by Uptime Institute
Case Study –Greenfield Data Center of 3.78 MW at Muscat

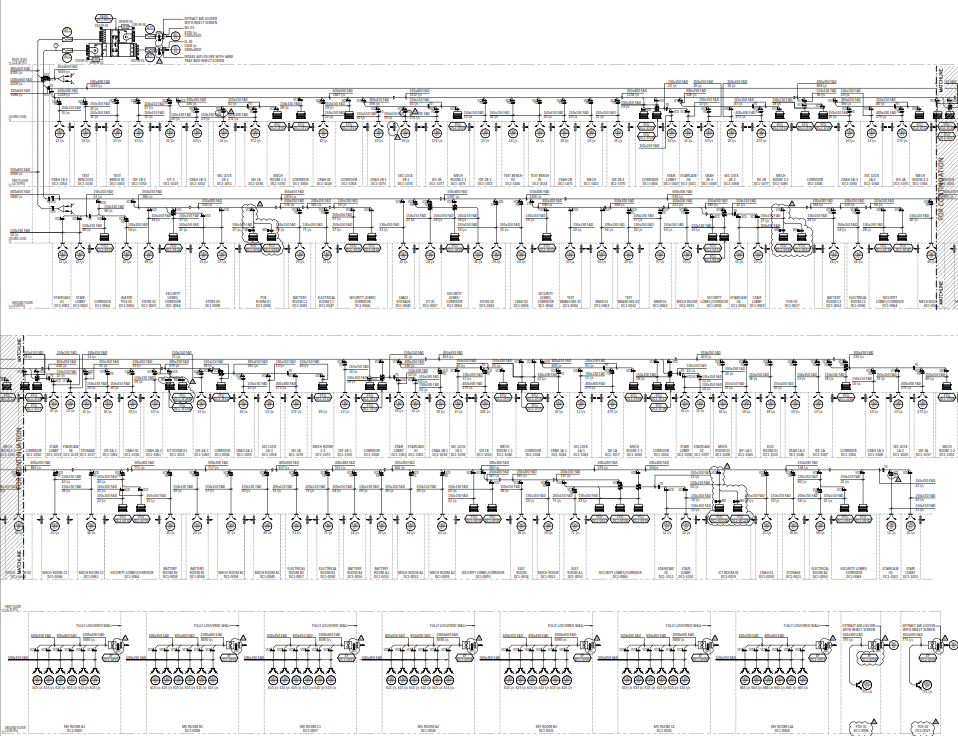

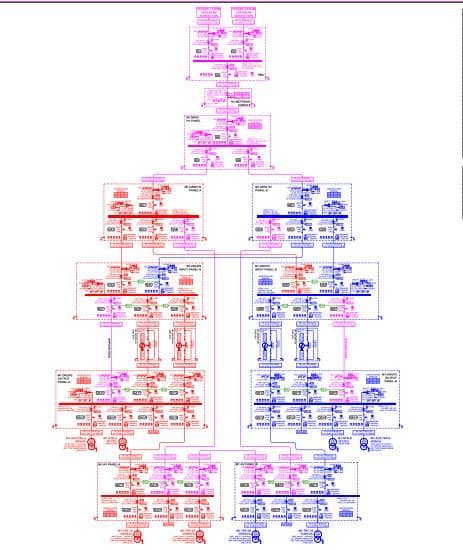

Power Flow Diagram
Campus layout drawing
HV Side Schematic Diagram
Datacenter site plan
LV Side Schematic Diagram
Power and OFC trench routing
Terrace Equipment Layout
Data hall equipment layout
Ground Floor Chilled water Layout
DR-UPS room layout
Chiller Plant Piping Schematic
DR-UPS room layout
Case Study 4-Design & Consultancy experience/Capability showcase (for a 4.5MW Tier III Greenfield DC in Bangalore)
Rajasthan State Data Center building
Project Brief

Designing, Building, Testing, and operating of a Data center at Bangalore meeting to Uptime Institute Tier- III guidelines .

The Site Location was on a Hill of 45 m above road level, rocky area, in a plot of 10 acres land. Hill chopped off to 22 Mtr level from road level and developed the Datacenter.

Net Design Capacity of 28. and Phase – 1 was built for 7.5 MW Capacity.

Space Allocated and MEP Equipments Considered
  • Facility includes Ground Floor and First Floor with 2 Server Halls on each floor.
  • Space planning done to accommodate 264 IT Racks, with Dual Telco Rooms, Electrical Rooms, Material Handling Area, and Office Space.
  • Designed to meet Uptime Institute Tier-III Standards.
  • Electrical System in N+1 Configuration with 11 KV Rotary Diesel Engine Generators feeding Transformers, stepped down to utility voltage for the complete facility.
  • Mechanical System in N+1 Configuration with CRAC units and PAC units for Non-Critical areas.
  • FM-200 Gas system implemented for Fire Suppression.
  • BMS, CCTV, EPMS, VESDA, WLD, Access Controls, and FAS integrated into the facility.
Building Planning
  • Developed Raised Floor of 750 mm height.
  • Implemented Cold Aisle Containment to improve PUE efficiency.
  • Created separate partitions to isolate IT Space from Non-IT Space.
  • Installed indoor units adjacent to external walls with outdoor units placed directly outside, minimizing low-side materials and overall cost.
  • Planned power distribution from HT Room to IT Racks in a straight line, ensuring easy identification, reduced power losses, and material cost savings.
Rajasthan State Data Center building

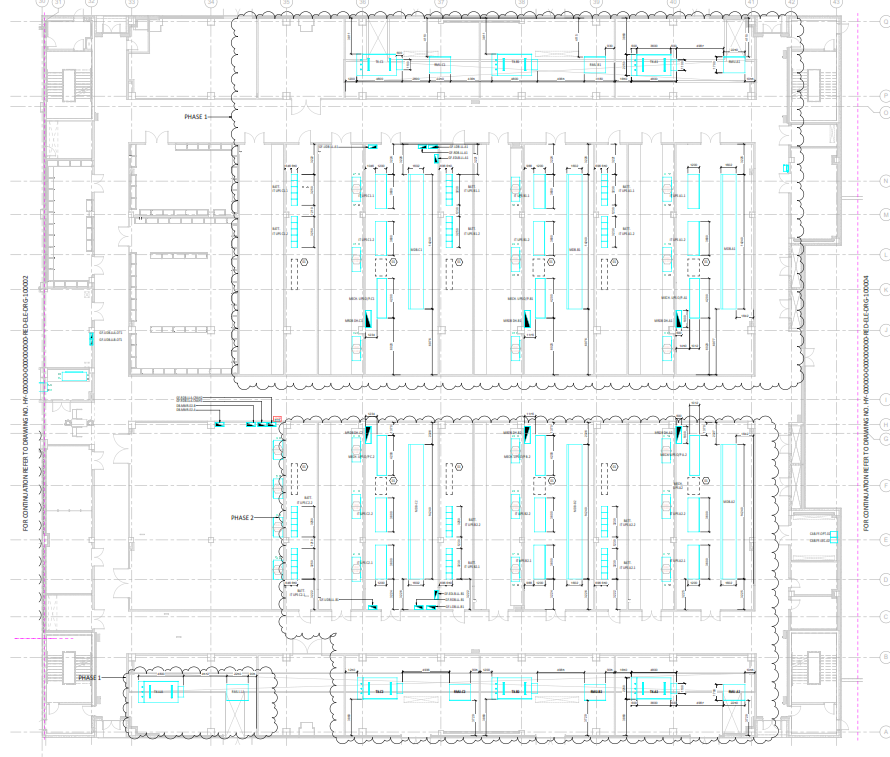

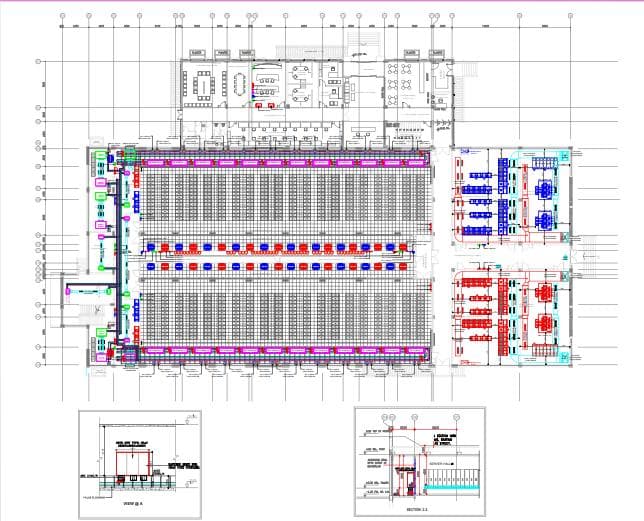

Data hall Equipment Layout
  • Total Design Capacity: 28 MW, implemented in 4 Phases.
  • Phase 1 IT Load: 3.0 MW.
  • Total Facility Load: 4.5 MW.
  • No of IT Racks: 500.
  • Rack Power Density: 5 kW per rack.
  • Datacenter Rating: Tier III Compliant.
Main Single Line
Campus layout drawing
Equipment Distribution SLD
Campus layout drawing
Equipment power distribution Layout
Campus layout drawing

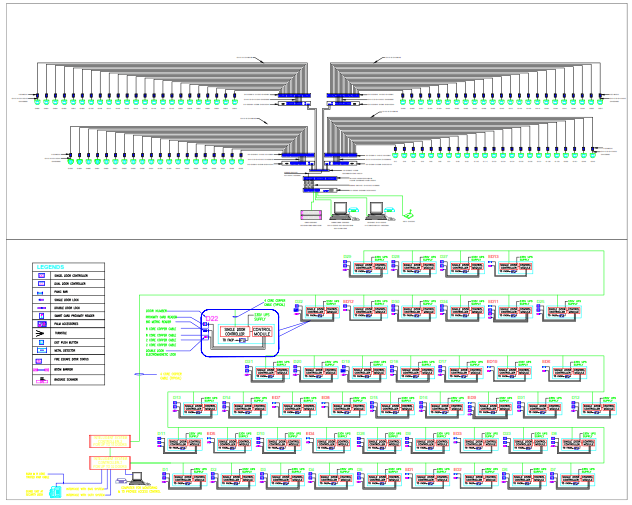

CCTV Access Control Schematic Diagram
Campus layout drawing
Case Study 5 –Design Peer Review - Greenfield Data Center of 20 MW at Dammam, KSA
Rajasthan State Data Center building
Project Brief

Design Validation and Peer Review of a 20 MW Datacenter developed at Dammam, Saudi Arabia.

Key Considerations
  • Pear Review of the Design Documents, Design Calculation, Simulation Studies.
  • Validating the Design, Equipment Specifications, .
  • Preparation of Report, with valid comments, suggestions,
  • Validating the Method Statements for installation process, Testing and Commissioning processes, Certification Processes,
General Site Layout
  • Ground Floor , Utilities in the ground floor, :- DG Sets Adjacent to Main Bldg, Water Tanks,on periphery, Electrical Room, ICT Rooms
  • First Floor, 4 Data hall, Each 5 .0 MW, Hot Aisle Containment, All Control Rooms,
  • Terrace , Chiller Plant, IDEC Units, Pumps and Accessories.
Cooling and Mechanical System
Terrace Equipment
  • Terrace: Chiller Plant, IDEC Units, Pumps, and Accessories.

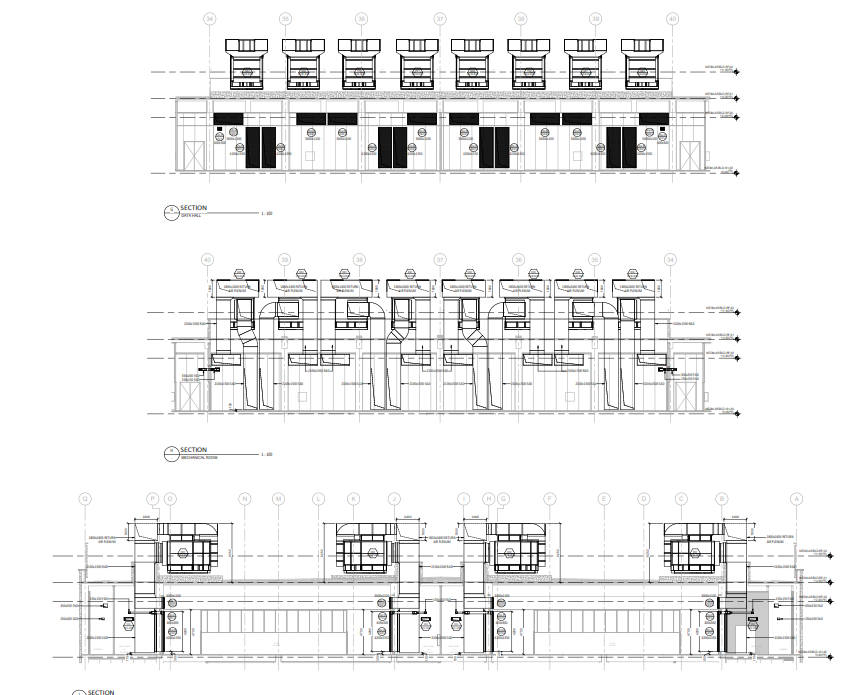

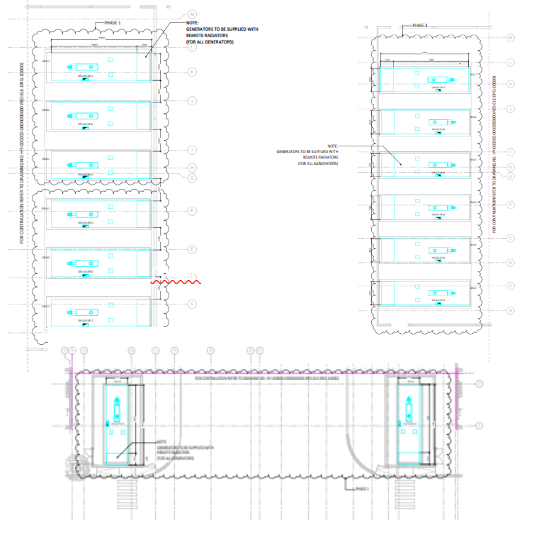

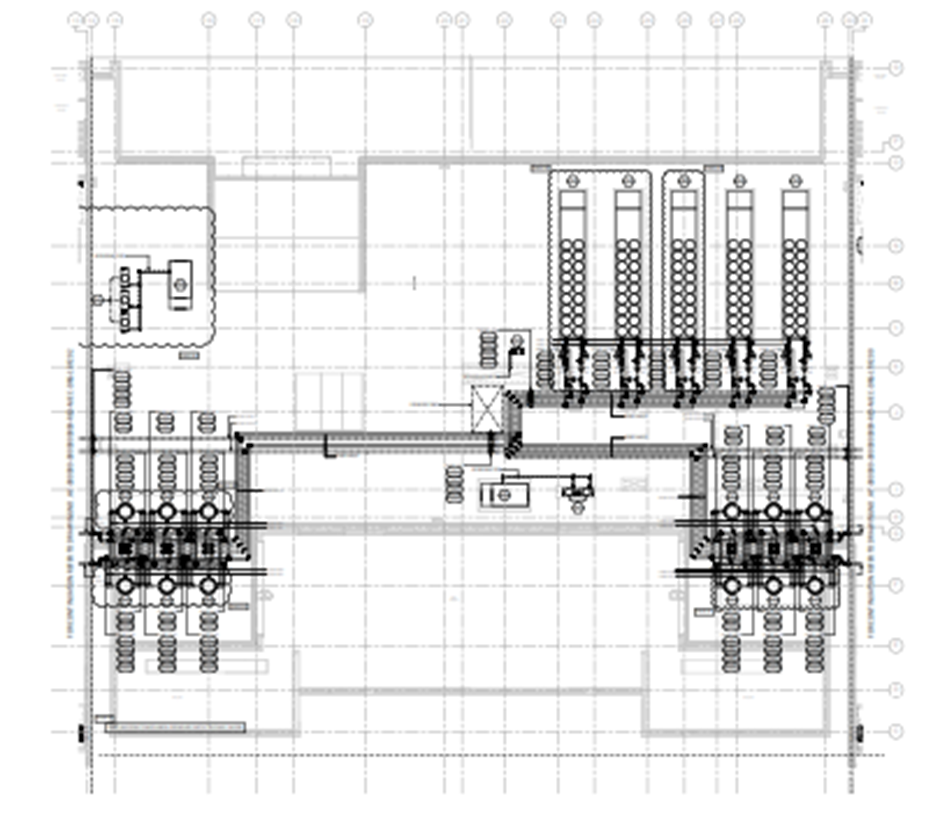

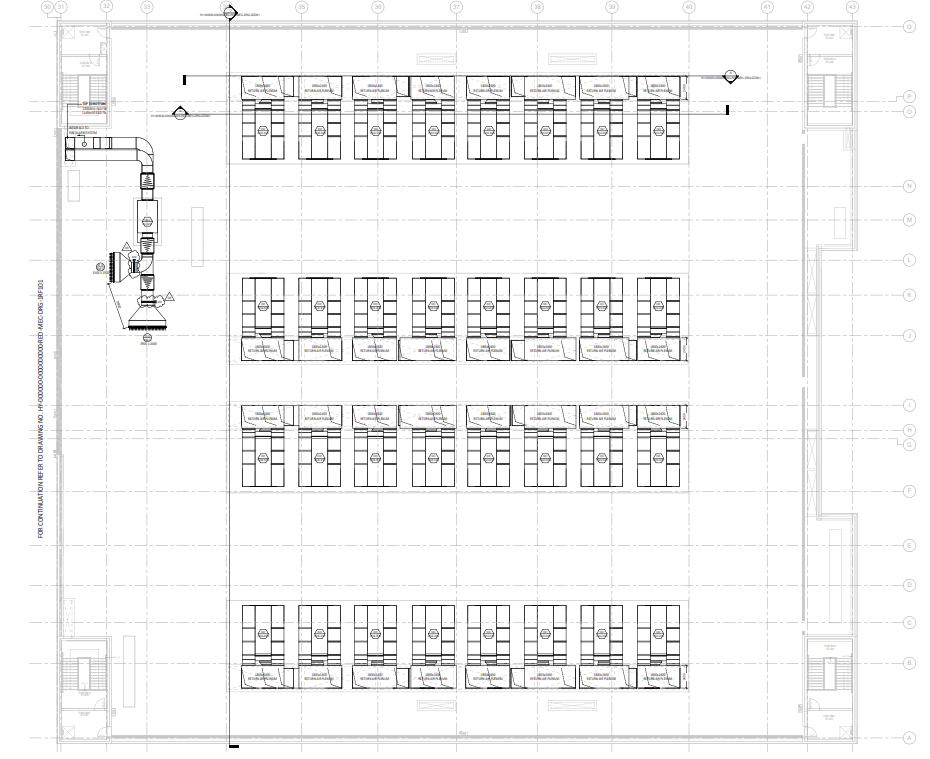

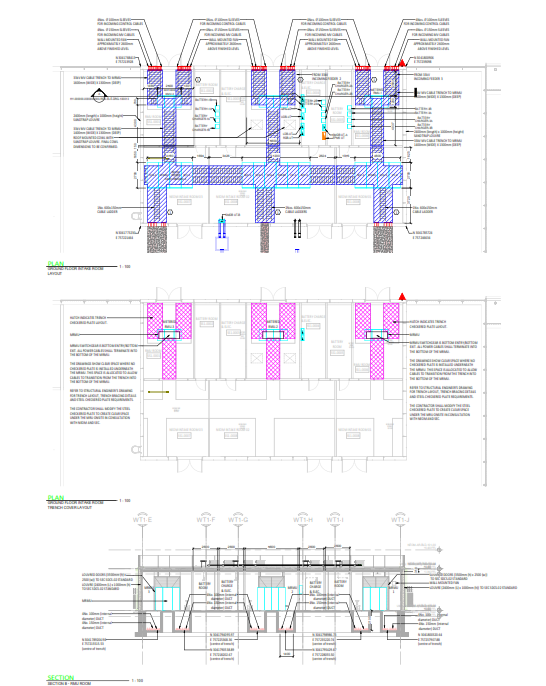

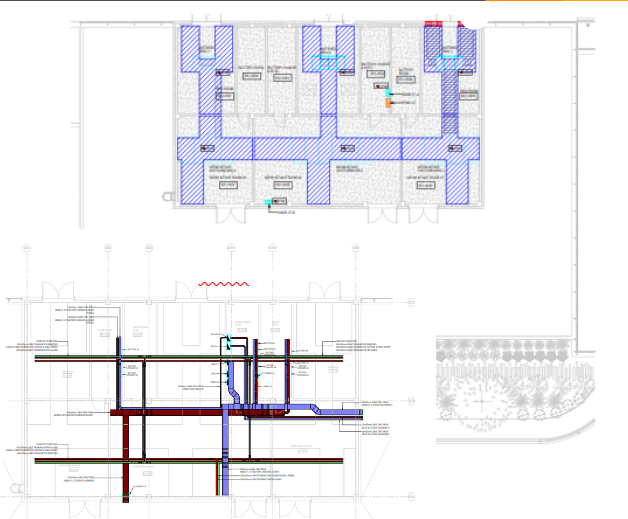

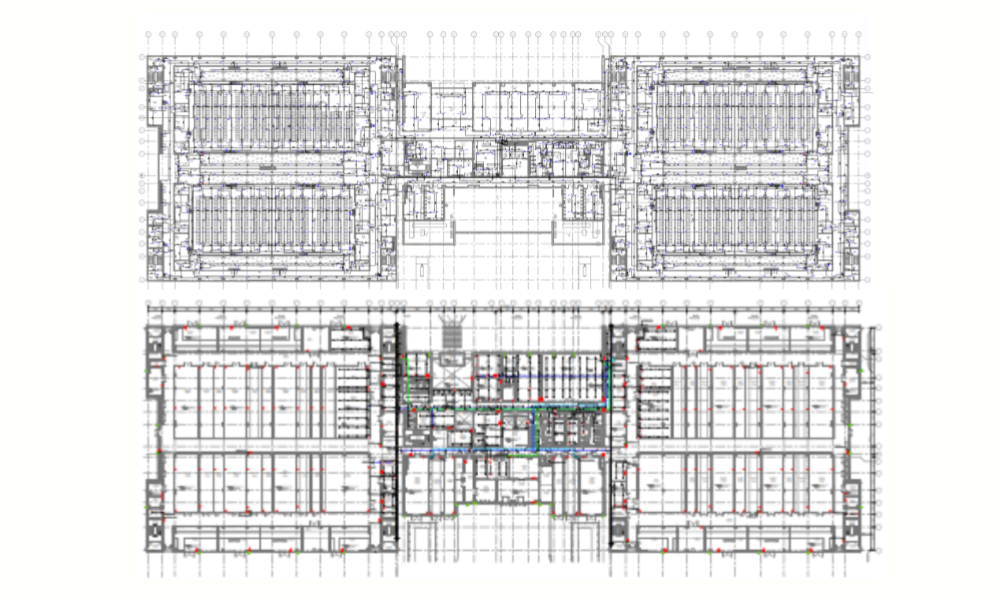

Mechanical layout – left sheet

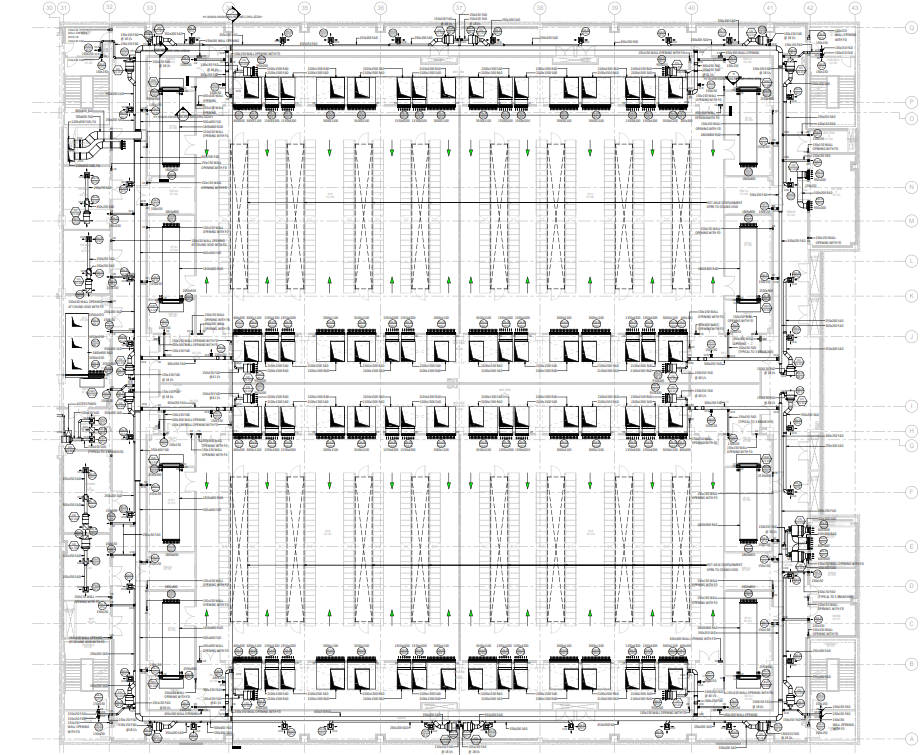

Mechanical layout – right sheet
Cooling and Mechanical System
Terrace Equipment
  • Terrace: Chiller Plant, IDEC Units, Pumps, and Accessories.
Mechanical layout – left sheet
Mechanical layout – right sheet
Cooling and Mechanical System
Terrace Equipment
  • First Floor : 4 Data hall, Each 5 .0 MW, Hot Aisle Containment, All Control Rooms,

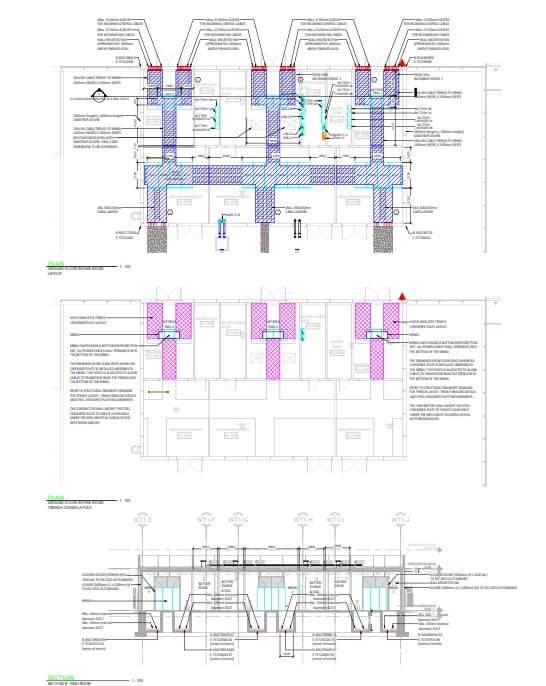

Mechanical layout – left sheet
Mechanical layout – right sheet
Electrical System,
Terrace Equipment

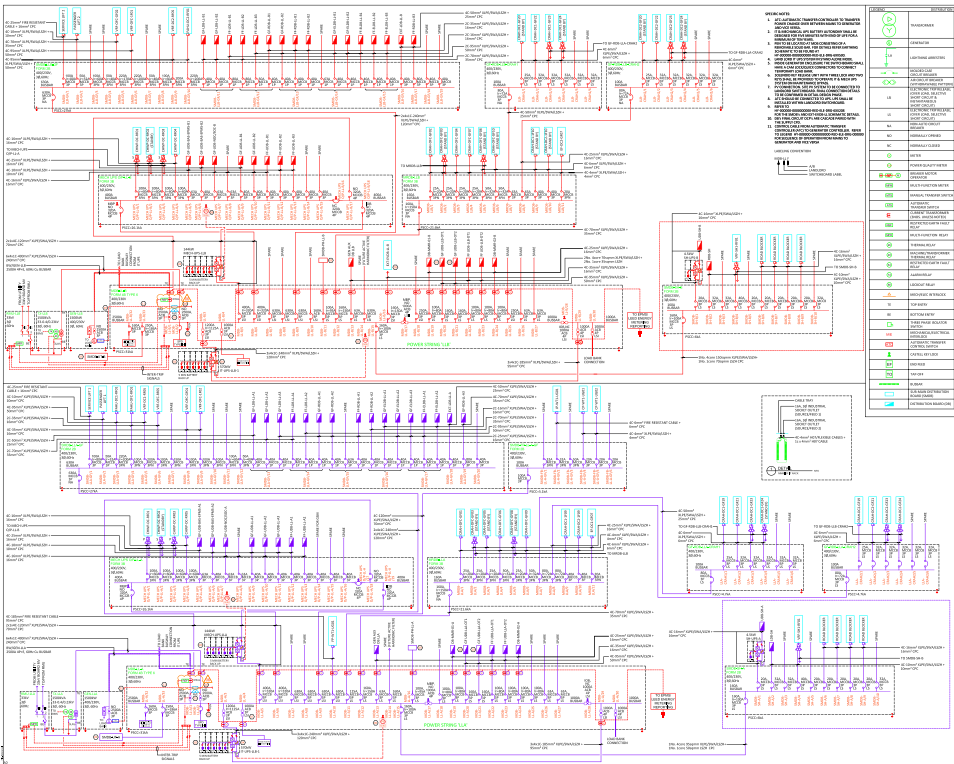

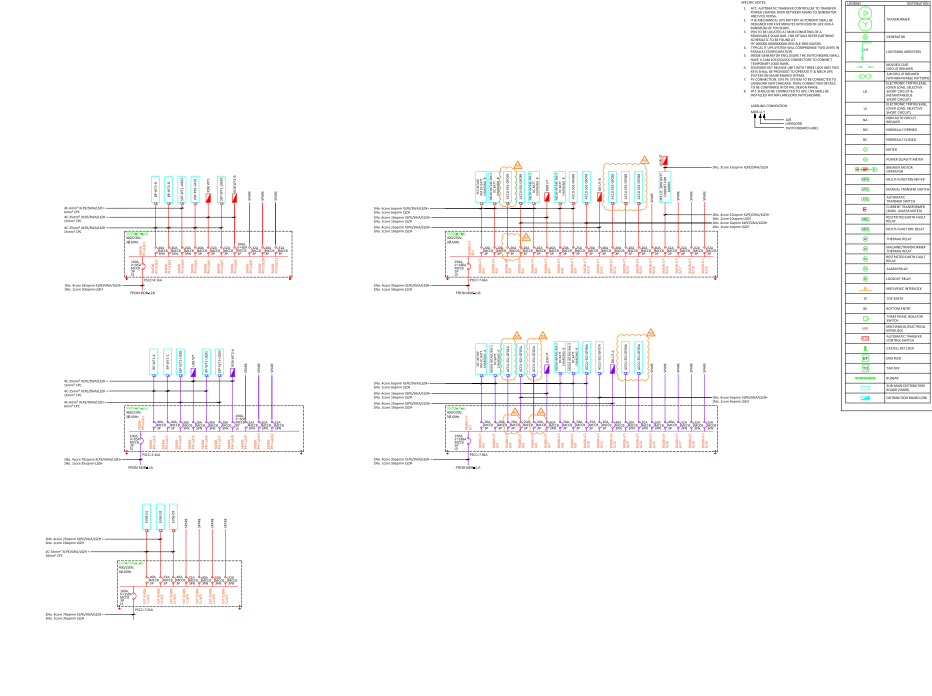

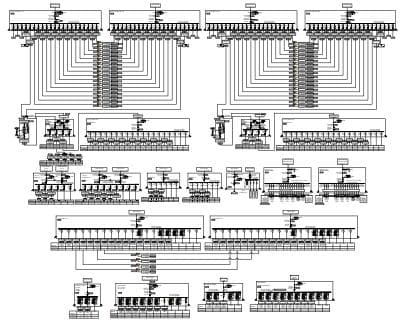

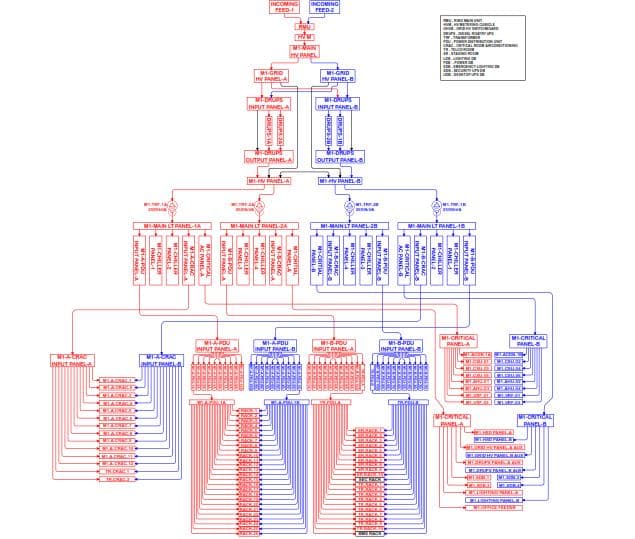

  • Electrical Single Line diagram ( Typical)

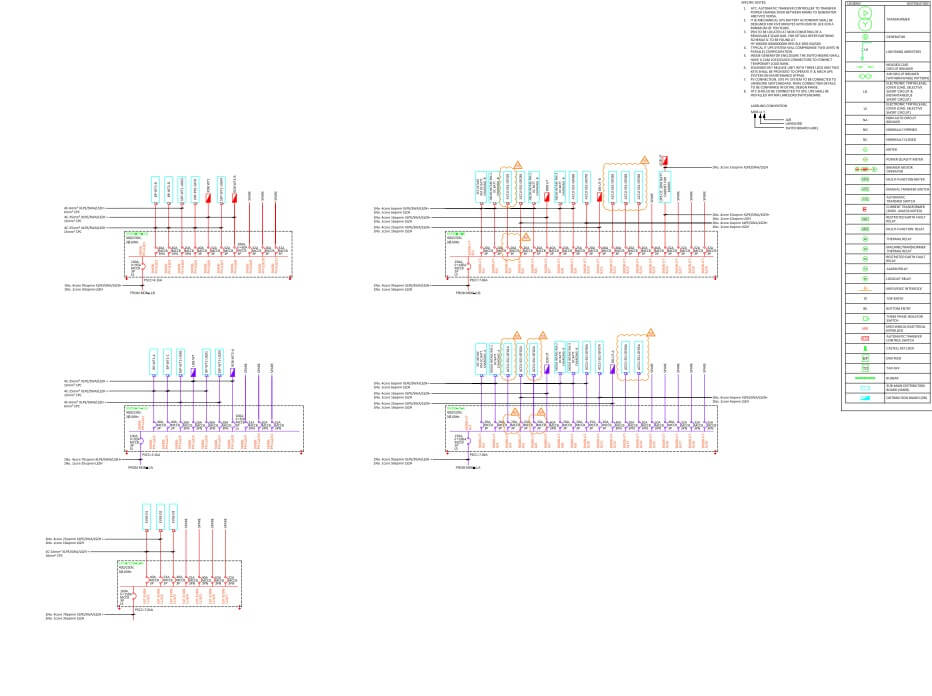

Mechanical layout – left sheet
Mechanical layout – right sheet
Electrical System,
Terrace Equipment
  • Electrical Room Equipment Layout, Generator yard Layouts
Mechanical layout – left sheet
Mechanical layout – right sheet
Electrical System,
  • Utility Building Laout, Trench Layout, Typical Cable tray Layout
Mechanical layout – left sheet
Mechanical layout – right sheet
Fire Alarm System
  • Fire Alarm System First Floor Master Plan
Mechanical layout – left sheet
Terrace Equipment

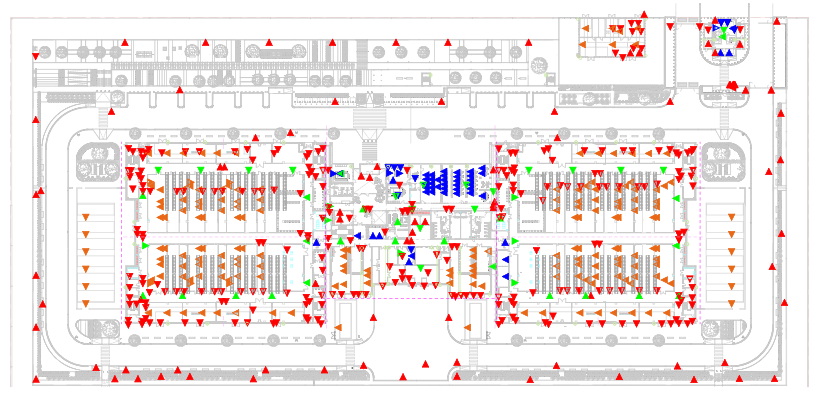

ICT Layout

Fibre path to DC building and Internal Trench arrangement

Mechanical layout – left sheet
Mechanical layout – right sheet
logo
About Us

Future Netwings’ business achievments have been recognised many times. There are awards like IDG Hall Of Fame, ChannelWorld, DQ Network Solutions Champion of the Year ,ITPV Best System Integrator and Dun & Bradstreet’s India’s Leading Small and Medium-sized Enterprises of the Year.

© 2025 Future Netwings. All Rights Reserved.
